Vitreous Labs· Great Britain
Findings

What the published data actually shows

Each of these comes out of the same pipeline that feeds the tool. Every figure traces to a published file, and anything inferred says so.

No permitted battery capacity remains in any zone

NESO rations connections against the Clean Power 2030 targets. Queue formation allocated all of the battery allowance, and the published remaining figure is zero in all nineteen zones.

Read it →

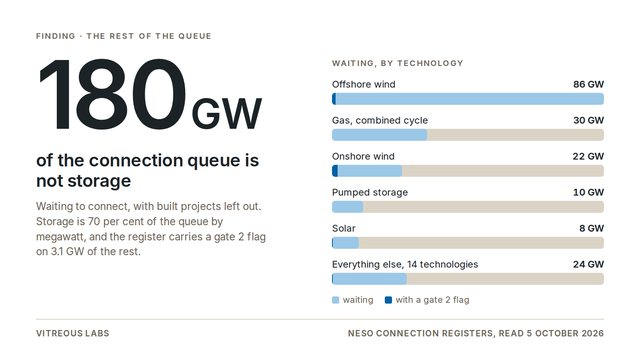

120 GW is queued at connection nodes that do not exist

122 strategic connection nodes created by the connections reform hold 120 GW of contracted storage between them, and not one megawatt of Gate 2.

Read it →

A battery in North Scotland is turned down thirty one times as often as it is turned up

A full year of Elexon settlement data across 97 per cent of the operating fleet shows a clean north to south gradient: the further north an asset sits, the more the system uses it as a sink and the less it earns.

Read it →

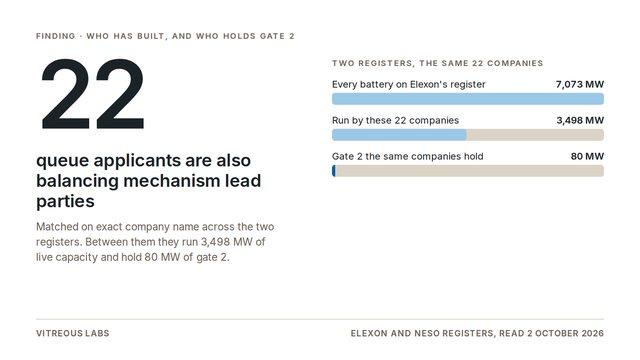

The operators who have built batteries hold almost no Gate 2

Nineteen companies in the connection register are the same registered entity as a lead party trading a battery today. Between them they hold 500 MW of Gate 2, all of it at one applicant.

Read it →

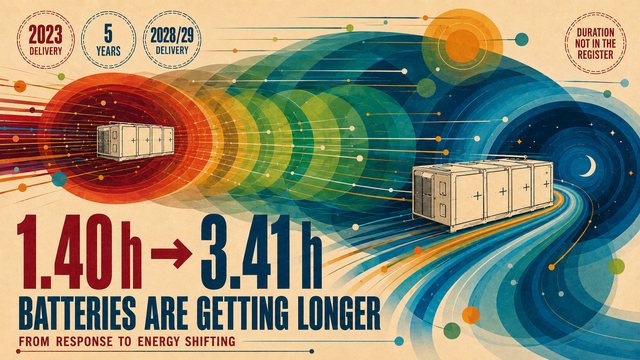

Battery duration has risen from 1.4 hours to 3.4

The capacity market de-rating classes state duration explicitly. Weighted by connection capacity, it has more than doubled across five delivery years.

Read it →
